Tips and Tools

Scroll this page for useful tips, tools and videos for using Microsoft Project.

Discover handy information, shortcuts, videos and best practices to make your workflow more efficient.

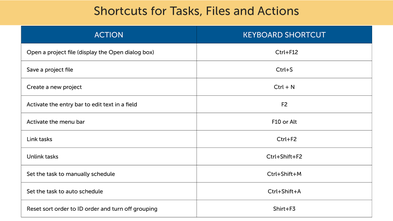

Keyboard Shortcuts

Learn helpful hot keys for using Project and navigating views.

Schedule Outline Tips

Learn tips for structuring tasks and creating your schedule outline.

Workflow Tips

Learn useful tips that can improve your workflow.

Videos

 Watch video demonstrations on how Project handles cost and other features.

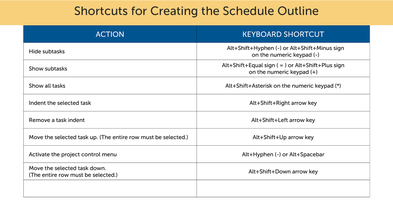

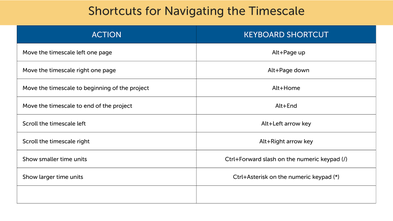

Keyboard Shortcuts

Below you'll find helpful keyboard shortcuts for navigating  views and windows in Project.

Schedule Outline Tips

Below you'll find helpful tips for creating the schedule outline and structuring tasks.

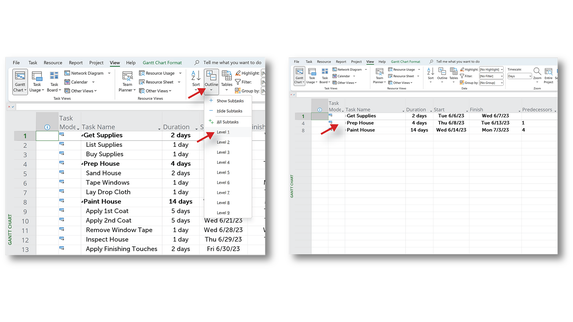

How to Check Your Schedule Outline

Step 3 in the B.A.S.I.C.S. 6-step schedule process is to Structure the Tasks to create your schedule outline.

As you structure the tasks, it’s helpful to check your project outline to ensure that summary tasks and subtasks are properly aligned. A handy way to do this is to use the Show Outline command. This feature lets you specify the outline level of the plan you want to view. Also, with larger projects, you can collapse the outline to specific levels of the project and expand only the sections that you want to work with.

To use the Show Outline command:

  • Select the View tab.
  • In the Data group, select the outline level you want to view from the Outline command picklist.

It's also helpful to use the Add New Column field to add the "WBS" column to the Entry table.

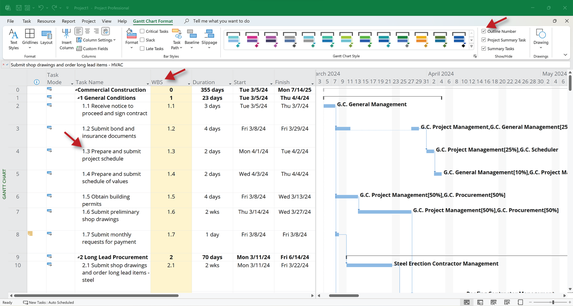

Display the WBS Codes and Outline Numbers

Another handy way to check your project outline and ensure the tasks are structured correctly is to display the WBS and/or Outline numbers in your schedule.

Here’s how to do it:

Display WBS Codes

Add the WBS field to the Entry table of the Gantt Chart view. A good place to add the file is next to the Task Name field.

  1. Right-click the Task Name field header. Then, select Insert Column from the picklist.
  2. Type and select WBS to insert the WBS field into the Entry table.

Display Outline Numbers

Display the task Outline Numbers with the task names.

  1. Select the Format tab.
  2. In the Show/Hide group, select the Outline Number checkbox. The task outline numbers will display next to the task names.

Workflow Tips

Below you'll find helpful tips for making your workflow easier and more efficient.

Expand each topic to see the tips and instructions

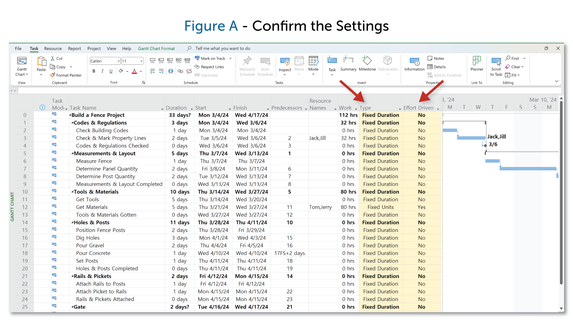

Confirm the Settings

Step 2 in the B.A.S.I.C.S. scheduling process is Adjust the Settings. This is a very important step. Selecting the right settings helps ensure Project behaves the way you need it to behave for your project!

To be sure you've selected the right settings, you can use the Add New Column field to add the respective fields to the Entry table (see Fig. A below).

Confirm Task Type Setting

  • Add the Type field to show the Task Type for each task.
  • Add the Effort Driven field to show if the Effort-Driven Scheduling feature is enabled for each task.

To learn more about adjusting the settings in Project, check out Chapter 5 and Chapter 7 in the Microsoft Project B.A.S.I.C.S. book or video course.

Assigning Resources in a Simple Schedule

In Chapter 8 you learn how to add resources to your schedule. In a Simple schedule, you can assign resources to tasks by simply typing their names directly into the Resource Names field of the Entry table.

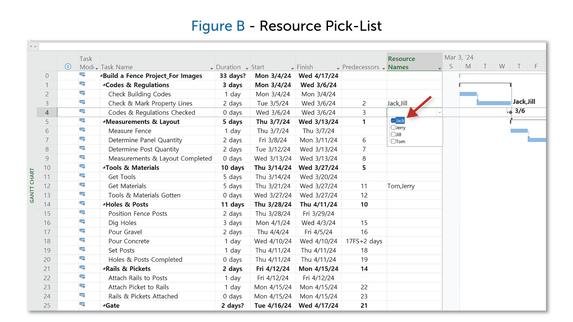

DID YOU KNOW… once you initially enter resource names into the Resource Names field, Project automatically creates a picklist of the names, so you can quickly assign them to tasks (as shown in Fig. B below).

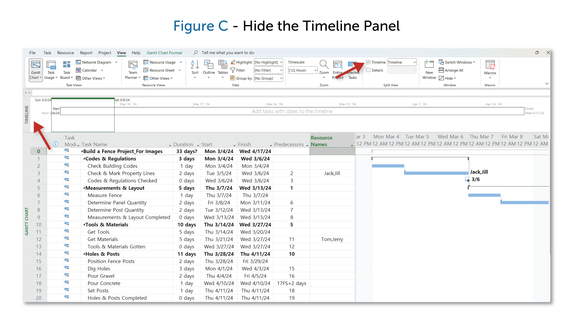

Hide the Timeline Panel View

Want more real estate in your current view?

By default, when you open a new project plan, an empty Timeline view panel will be displayed beneath the ribbon. In Chapter 17 you learned how to use and customize this panel to summarize your project and create dynamic status reports.

When you’re not using the Timeline view, you may want it out of your way, to see more of the current view (see Fig. C below).

Here’s how to do it:

  1. Selecting the View.
  2. In the Split View group, uncheck the Timeline checkbox.

That's it!

Splitting Tasks

In Chapter 13 we discuss ways to level over-allocated resources. One way to resolve over-allocations is by splitting tasks.

If you need to interrupt work on a task, you can split the task so that part of the work starts later in the schedule. Tasks can be split in the Gantt chart view using the Split Task command and simply dragging the task bar to split the work. While this method is quick and easy, some users find it tricky to perform.

Another way to split a task is by adjusting the work hours in the Resource Usage or Task Usage views. In either view, to split a task, zero out the work hours (enter 0h) on the days that you don’t want any work to occur.

Here are some additional tips for splitting tasks:

Change the Duration of a Split Task

You can change the duration of the entire split task (including all its sections) by typing the new duration in the Duration field. You can also change adjust the duration of each section of a split task?

Here’s how to do it:

  1. Hover over the right end of any part of the split task until the cursor changes to an expansion arrow.
  2. Drag to the left to shorten the duration of the part or drag to the right to lengthen the duration.

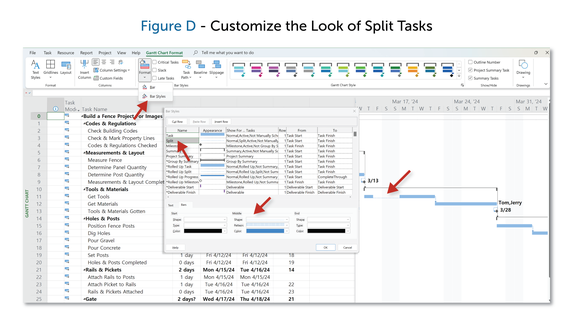

Customize a Split Task

Want your split task to stand out? DID YOU KNOW you can modify the Gantt bar style for split tasks? By default, split tasks are represented in the Gantt Chart view with dotted lines connecting each split portion. You can change the appearance of the split task by modifying the split bar style (see Fig. D below).

Here's How:

  1. Go the Gantt Chart view.
  2. Select the Format In the Bar Styles group, select the Format Bar Styles from the Format command picklist to open the Bar Styles dialogue box.
  3. In the Name field, select Split from the list.
  4. In the Appearance field, select the style you want to represent split tasks.
  5. On the Bars tab, in the Middle column, select the options you want for the split task bar in the Shape, Pattern, and Color fields.

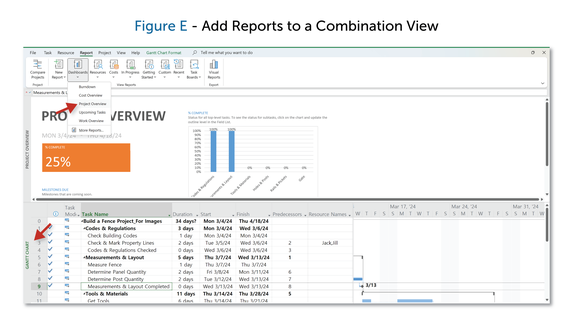

Add Reports to Combination Views

In Chapter 17 we explained how to use Project's reporting features to create dynamic project status reports.

DID YOU KNOW you can add a report to a split combination view? This allows you to see the report update in real time as you work on project data.

Here's how to do it!

First, create and customize the report you want (see Ch. 17 for details).

Next, split the view:

  1. Select the View tab. In the Split view group, select the Details check box.

Next, add a report to the split view:

  1. Click anywhere in the top pane to select the top part of the view.
  2. Select the Report tab. In the View Reports group, select the report you want from the report options. The report will be added to the top pane of the view.

Last, add the view you want to the  bottom pane of the view. E.g., the Gantt Chart view (see Fig. E below).

  1. Click anywhere in the bottom pane to select the bottom half of the view.
  2. Select the View tab. In the Task Views or Resource Views group, select the view for the bottom pane of the view.

Task Constraints

Do you have unwanted constraints in your schedule?

When you’re in the Automatic scheduling mode it’s generally a bad idea to manually enter task start or finish dates. Doing so will cause Project to create constraints, which will limit your schedule’s flexibility. For example, entering a start date will cause Project to create a Start No Earlier Than constraint, which will prevent the task from starting earlier, if possible.

By default, Project starts each task as soon as possible, and automatically calculates start and finish dates based on task relationships and other things like calendars.

It’s best to avoid entering start and finish dates and let Project automatically determine them using its scheduling engine.

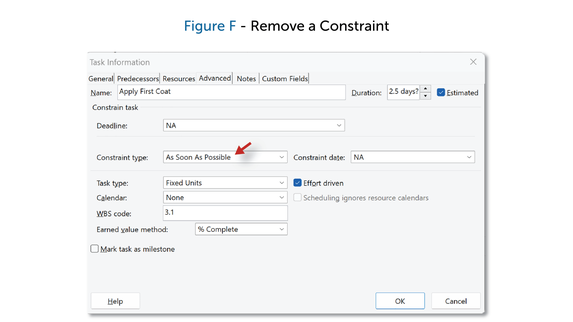

To Remove a Constraint:

  1. Double-click the task to open the Task Information dialogue box (see Fig. F below).
  2. Select the Advanced
  3. In the Constraint type field, select the default As Soon As Possible constraint type.
  4. Select OK to close the Task Information dialogue box.

Learn more about constraints in Chapter 12 .

How Project Handles OT Cost

Below you'll find information and a software demonstration on how Project handles
overtime cost.

How Project Calculates Overtime Costs

In Chapter 16 we discuss how Project tracks project costs. When you build a Detailed schedule, Project calculates the cost of tasks by multiplying the Standard rate of pay of the resources assigned to it by the work required to complete the task.

DID YOU KNOW… Project DOES NOT calculate the cost of additional work hours (Overtime) by using the overtime rate that you entered until you specify those hours as overtime work? For example, if a resource is scheduled to work 8 hours a day and they enter 12 hours of actual work, Project doesn’t automatically consider the additional 4 hours as “overtime work” and won’t use the resources overtime rate until you tell it to.

Here’s how to do that.

  1. Go to the Task Usage view.
  2. Change the table to the Work.
  3. Add the Overtime Work column to the table.
  4. In the Overtime Work field of the resource’s assignment for which you want to enter the overtime work, enter the amount of overtime work for the resource.

* Add the Overtime Cost field to a task view to view the overtime costs.

Watch the video below to see a demonstration on this feature.

How Project Handles Overtime Costs

Watch the video on the left for a software demonstration of the feature explained above.
